Session 6 Commentary

AGENDA

Assignment II Presentations:

Reconsider:
   User Support & Training
   Help Desk
   Staff Training

Break

Review:
    Change Management Primer
    Risk Management


Discussion Questions

QnA on Assignment 2

Assignment II Presentations

Discussion Questions

-- What are the three greatest risks to an application's successful implementation?  Give specific reasons for each risk's selection.  Teams 2, 5, 8
-- What lessons can be gleaned from the Y2K experience?  How can these lessons be applied to new situations?   Teams 3, 6, 9, 10
-- What roles can DSS (Decision Support Systems) and EIS (Executive Information Systems) play in managing risks? Teams 1, 4, 7



Reconsider User Support, Help Desk, Information Center

Help Desk Scope

Driven by Support Strategy

What does HELP DESK really do?

Need to define in advance (manage expectations) and measure performance

Define contact procedure
1-800-HELPME2, for example

HELP DESK Models

Most prevalent models

Three tier model – all issues

Two tier model – selected/new applications

Two tier model – all issues

Driven by Strategic Intent

Response time to caller

Response time to resolve problem

Part of support process to improve application

HELP DESK - 3 Tier



HELP DESK - 2 Tier





HELP DESK Tools

Help Desk Polarities

Typical Project Cycle

    Major Design and Business Considerations



User Support and Training

Operations Stage Cost Minimization-- comes from superior user support and training

Why?

How?

User Leaders --

Old Solutions for User Training

Application Support Team



Managing the Investment return

All functions must work together for same goal

Some historic boundaries (Mental and Physical ) need to go

Need to consider how to monitor the ongoing health and return from the investment



Break

Review Change Management Primer


CHANGE MANAGEMENT PRIMER

 the need for educated executives so IT innovations are possible.  Also discusses uses of meetings /seminars for bringing execs up-to-date.  Questionable success if IT mgt has no track record -- may seem self-serving.  Critical need is to understand the firm and its industry and the competitive forces that are working.

Focus for the class -- CIO + line mgrs-- managing the POLITICAL RISKS (see C.5 above) -- means for getting buy-ins from top mgt & mid mgt through-out the firm --

definition  -- change management (the overarching concept behind risk management) -- process of  assisting people in making major changes in their work environment.

Disruptive nature of change in a business person's life?

 Change Management Roles Involved

4 step approach for describing / assessing change (c.)

  1. describe the c.
  2. assess sponsor's commitment to c.
  3. evaluate support/resistance of targets.
  4. assess change agent's skills

The need for CHAMPION (someone who has vision and gets it implemented

How IS can help?

Champion needs from IS

End User Training

Computer-Based Training (CAI, CMI, CBT, IPSS)

End User Training Needs (5)

  1. IS concepts -- classes usually
  2. Quick start -- web browser for giving big picture
  3. Refresher aids -- embedded in s/w
  4. Explanation of assumptions -- embedded in s/w
  5. Help in overcoming difficulties  --HELP DESKS

Review Risk Management


Risk Management

A. Paul, Lauren Gibbons, "High Wire Acts," CIO 6/15/98,
http://www.cio.com/archive/enterprise/061598_risk_content.html

B. Hildebrand, Carol " A Road Map for Risk," CIO, 4/15/96
http://www.cio.com/archive/041596_method_print.html/

C.  Radosevich, Lynda and Cheryl Dahle, "Risk Management: Taking Your Changes," CIO 4/15/96,
http://www.cio.com/archive/041596_risk_print.html

D. Carol Hildebrand, "Beware the Weak Links," CIO 8/15/98.

Risk Management

Highlights from Web Based Articles

A. Paul, Lauren Gibbons, "High Wire Acts," CIO 6/15/98,
http://www.cio.com/archive/enterprise/061598_risk_content.html
smart companies take portfolio approach -
- a mix of high risk (high potential return)
- mid risk (mid potential return)
- low risk (low potential return)

understand EVERY ASPECT of the risk so you know the level of risk you are taking on

should FACTOR risk into their return on investment calculations -
- some might think activity is profitable when in fact is not -- why this happens -- risk is calculated on only 1 dimension from one group's point of view -

technological risks -- MS intro of new ergonomic keyboard -- legal liability for repetitive stress syndrome

- therefore use interdisciplinary teams (h/w, legal, finan, mktg, risk mgt-- probability of failure) to calc risk & dev strategies -- h/w designed best k/b, legal drafted warning msgs, mktg promised to NOT advertise k/b as an ergonomic cure-- calc % that have a potential for repetitive stress syndrome., cost of lawsuit defense & potential judgments, etc.

- Fidelity Management Trust Co.  log of every loss > $5000 with details on incident and what ctls were put in place to get around it.
getting the right measures, understanding root causes-- learn from mistakes

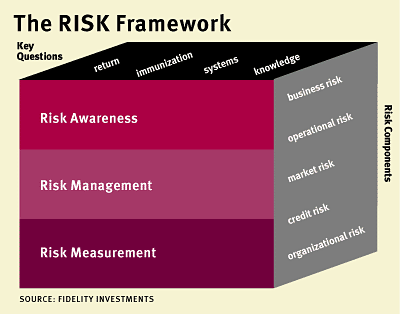

The Risk Framework



   "R" is for return: Are we achieving an appropriate return for the risks we take?
    "I" is for immunization: Do we have the controls and limits in place to manage downside risk?
    "S" is for systems: Do we have the systems to measure and report risk?
    "K" is for knowledge: Do we have the right people, skills, culture and incentives for effective risk management?
    These questions, as well as a listing of best practices for each category, appear on the Global Risk page of the corporate intranet--the hope is that they'll never be far from executives' desktops and minds.

-- For joint ventures & partnerships -- grief-to-revenue ratio


B.  Hildebrand, Carol " A Road Map for Risk," CIO, 4/15/96
http://www.cio.com/archive/041596_method_print.html/

"Often a CIO is so concerned with being an advocate for a project that he or she hides the uncertainties of a project" he (finance Professor Nalin Kulatilaka of Boston University) says. .. "not only did the CIO not get blamed for bad decision making, but his credibility increased.  By translating an IS project into terms of risk and rates of return, he could speak the same language as the CFO."

By using the model of options trading-- develop a flowchart ("tree") of decisions and their possible outcomes extending into 5 years into the future.. Then, probabilities of occurrence are attached.  Then the projects are done in modules where at each stage, the risks are reevaluated and recalculated.  If the project's success now is iffy and its likely payoff is too small then the project is canned.  Some of this modeling comes from Chaos theory -- particularly
"the butterfly effect" -- small changes can result in states totally different from the originally expected.  A butterfly fluttering in Argentina results in a snowstorm in Chicago five days later.

example -- early users of technology face more risks  than mid users or late users of same technology and therefore must expect a much higher rate of return starting sooner because higher risks must have bigger payoffs in order to make sense.

Risk Early Adopter Mid Adopter Late Adopter
hands-on implementation experience  little exper / high risk more exper / mid risk much exper / low risk
vendor survival for project after shake-out high risk mid risk low risk
sudden changes in direction of technology high risk mid risk low risk
integrating technology with existing portfolio high risk mid risk low risk
Benefits
Period for Start of Payoff  Short term Mid term Long term
SIze of Returns per period Biggest Bigger  Big




C.  Radosevich, Lynda and Cheryl Dahle, "Risk Management: Taking Your Changes," CIO 4/15/96,
http://www.cio.com/archive/041596_risk_print.html

presents a framework for making sure all major categories of risks are examined

1. Cost Analysis -- cost, savings, potential new revenues. -- start with demonstrating that new project's  Internal Rate of Return (IRR) exceed a set rate.

IRR is the discount rate at which the present value of the future cash flows of an investment equal the cost of an investment.  It is found by trial and error; it is the rate that occurs when the net present value of cash outflows (the cost of the investment) and the net present value of cash inflows (the returns on the investment) equal zero, the discount rate used is the IRR.

2. Opportunity Lost: the Risk of Inaction or Failure -- weighing the cost of NOT launching a project or FAILING in attempt.
    Those costs of a potential failure are subtracted from the expectied benefits to give the true costs.

3 . Vendor Management: Buying Smart -- negotiating with vendors and managing resulting contracts.  Assessing the costs that would incurr  if vendor goes out of business, or drops its support of a product that the firm bought,

4. Developing Practices: Getting It RIght -- setting clear business objectives. conducting modular projects. shortening development, increasing user involvement. and using more off the shelf software.

5. Political Risk: Stumping for the Project -- cannot be overemphasized that a CIO must get buy-ins from peers and superiors-- particularly when system spans functional areas (e.g., ERP) -- must not just get buy-in but also reassess situation constantly.

Ranking IT Projects -- {sum of reward factor scores - sum of risk factor scores} = Project Risk Score
   Higher the score the better.  -- list is a good place to start with risks, rewards, contract risks


D. Carol Hildebrand, "Beware the Weak Links," CIO 8/15/98.

The risks inherent in Supply Chain Managment (SCM) are explored.  The "gapping the line" risk -- causing a break in assembly line.

Solution:  cooperative, not antagonistic partner relations where meeting common goals means sharing more information and sharing logistic workload to get the goods where they need to be when they need to be there.

"But as chains linking suppliers, manufacturers, distributors and customers grow ever more intricate, so do the inherent risks.  One company's problem could have repercussions through a far wider array of companies and functions than ever before."

Risks:




Topics

Risk Mangement

What imperils the Benefits?

General Business Risks:


Ineffective use by users

Poor Training
    Poor Procedures


Inability to resolve problems

Poor Help Desk
    Poor Monitor/Control


Lack of trained support

Poor access to user support
    Lack of trainers

Risk Management Topics

Risk Management Overview - External Risks
(some others not mentioned in readings)

Risk Management Overview - Internal Risks



Risk Management Approaches



Management Processes

--Design issue

--Project issue

Implementation Issues

Questions to consider:

Risk Management Tools

Managing Distributed Computing Risks

Discussion Questions

- What are the three greatest risks to an application's successful implementation?  Give specific reasons for each risk's selection.  Teams 2, 5, 8
-- What lessons can be gleaned from the Y2K experience?  How can these lessons be applied to new situations?   Teams 3, 6, 9, 10
-- What roles can DSS (Decision Support Systems) and EIS (Executive Information Systems) play in managing risks? Teams 1, 4, 7.
